Staring down a critical sales deadline for a new product launch or promotional event can be stressful. The biggest question looming is often about the custom mugs production time, and you worry that a delay could mean missing your window entirely. The solution isn't just getting a single number from a factory; it's about understanding and managing the entire project timeline from start to finish.

Based on my 15 years of experience exporting custom ceramic mugs, a realistic timeline from initial design discussion to having goods in your warehouse is 3 to 5 months. This total lead time includes approximately 3-5 weeks for pre-production (design and sampling), 30-45 days for mass production, and 30-50+ days for international shipping and customs clearance.

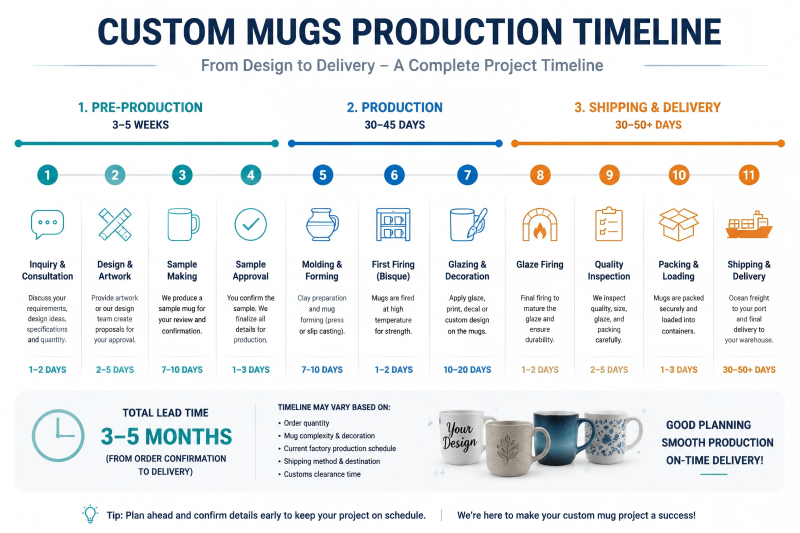

A detailed project plan showing the custom mugs production time from design to delivery.

That timeline might seem longer than you expected. This is because "production time" is just one piece of a much larger puzzle. To truly get your mugs on time, you need to think like a project manager. Let's break down each phase so you can plan effectively and avoid costly delays.

How Does Pre-Production Affect Custom Mugs Production Time?

You have a fantastic design idea ready to go, and you're eager to start manufacturing. However, you might not realize how easily small issues in the design and sampling phase can create a cascade of delays that eats into your schedule. Mastering this first stage is the secret to a smooth project.

The pre-production phase, which covers design finalization and physical sampling, typically takes 3 to 5 weeks. It is the most variable part of the entire project and, in my experience, the number one source of preventable delays.

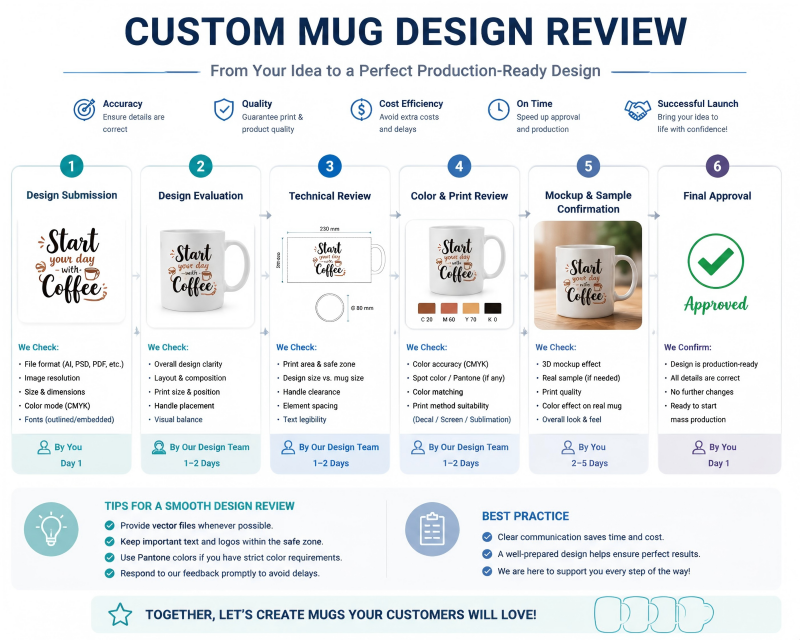

Designer reviewing a technical drawing for a custom logo mug supplier.

Dive Deeper: From Idea to Approved Sample

The journey from a concept to a "golden sample" approved for mass production is where many importers lose valuable time. Your goal here is to be as clear and decisive as possible to keep the project moving forward.

H3: The Critical Role of Design Files

The quality of your communication starts with the quality of your artwork. I've seen firsthand how this can make or break a timeline.

  • Rookie Mistake: A new e-commerce seller once sent us a low-resolution JPEG logo they pulled from their website. It looked fine on a screen, but when enlarged for a mug, it was pixelated and unusable. This led to a week of back-and-forth communication as we tried to explain vector graphics and help them recreate their art. That one-week delay pushed their entire schedule back.
  • Pro Best Practice: Experienced clients provide print-ready artwork from the start. They send us vector files (.ai, .eps, .svg) with specific Pantone color codes. This allows our design team to create an accurate digital mockup within 24 hours and move directly to sampling.

As a private label mugs supplier, our job is to bring your brand to life. Providing clear, technical files makes this process faster and more accurate. This is a key difference when considering OEM vs ODM Ceramic Mugs, as OEM projects rely entirely on your design specifications.

H3: The Sampling and Feedback Loop

Once the design is confirmed, we create a physical sample. This is your chance to see, touch, and approve the final product before committing to thousands of units. Efficient feedback is essential.

  • Vague Feedback: "The color looks a bit off." This forces us to guess. Is it too light? Too dark? Too saturated? This kind of feedback often requires us to produce multiple new samples, with each new round adding 7-10 days to the schedule.
  • Specific Feedback: "The blue (Pantone 286 C) looks correct on the handle, but on the body, it appears 10% too light. Please adjust for the next sample." This gives our technicians a clear, actionable instruction, dramatically increasing the chance of getting it right on the next try.

The sample is your quality benchmark. The faster you can provide clear, specific feedback, the faster we can move toward mass production. A reliable custom logo mug supplier will guide you through this, but your preparation is the biggest accelerator.


What Is the Actual Manufacturing Time for Custom Mugs?

Your sample is approved—congratulations! Now the factory floor springs to life. You might think this part is a fixed number, but the actual custom mugs production time can vary based on several factors. Understanding the process helps you appreciate why a simple mug and a complex one have different timelines.

The core manufacturing process for a standard order of wholesale custom mugs typically takes between 30 and 45 days. This timeline is influenced by your order quantity, the complexity of the mug's design and shape, and the factory's current production schedule.

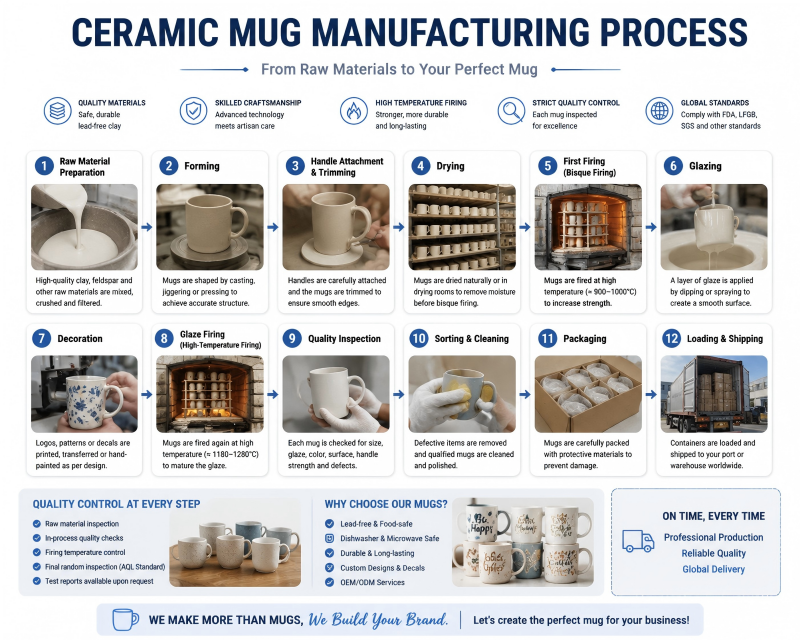

Rows of unfinished mugs in a ceramic mug factory in China, showing the scale of the ceramic mug manufacturing process.

Dive Deeper: Inside the Ceramic Mug Factory

Once we get your "go" signal, the order enters a multi-stage workflow. As an OEM ceramic mug manufacturer, we follow a precise sequence to ensure consistency and quality across thousands of pieces. Delays in one stage can create a bottleneck for the next.

The ceramic mug manufacturing process generally includes these key steps:

  1. Mold Making & Slip Casting (3-5 days): For custom shapes, a new mold is created. Liquid clay (slip) is then poured into molds to form the mug's body.
  2. Trimming & Finishing (2-3 days): Once semi-dry, excess clay is trimmed, and handles are attached by hand. The surface is smoothed.
  3. Bisque Firing (2 days): The "greenware" mugs are fired at a low temperature (~800°C) to harden them into a porous state, ready for glazing.
  4. Glazing (2-3 days): Mugs are dipped in, or sprayed with, a liquid glaze. This is a critical step for color and finish.
  5. Decal Application (3-5 days): For complex logos or full-wrap art, printed decals are carefully applied to the glazed surface by skilled workers. This is more time-consuming than simple screen printing.
  6. Glost Firing (2 days): The mugs are fired at a high temperature (~1200°C). This melts the glaze into a hard, glassy layer and fuses the decal permanently to the mug.
  7. Quality Control & Packing (3-5 days): Every single mug is inspected for defects. Approved mugs are then cleaned, packed into inner boxes, and then into master cartons for shipping.

The complexity of your design has a direct impact on this timeline and cost. For a detailed look at how these factors influence pricing, our Ceramic Mug Cost Breakdown guide is a great resource.

Feature Complexity Estimated Time Impact Why It Takes Longer
Standard 1-Color Logo Baseline (30-35 days) A simple, fast screen-printing process.
Multi-Color/Wrap Decal +5-7 days Requires precise, manual application of decals on every mug.
Custom Shape/Mold +7-10 days Requires initial mold production and testing before mass production.
Special Glaze +5-7 days Reactive or temperature-sensitive glazes require more precise firing curves and higher QC rejection rates.

Furthermore, the size of your order matters. A larger order doesn't necessarily mean a proportionally longer timeline, but it does require more machine and labor hours. Your order will be scheduled alongside others, so confirming your order early secures your spot in the production queue. This is especially important when considering the factory's MOQ Guide for Custom Mug, as meeting the minimum helps streamline production.


How Does Shipping Impact the Total Custom Mugs Production Time?

Your mugs have passed final inspection and are packed securely in cartons. The project is almost done, right? Not quite. They are still in a factory in China, and getting them to your warehouse in Europe or the Americas is the final, and often longest, leg of the journey.

International shipping and customs clearance is a major phase that can easily add 30 to 50+ days to your total custom ceramic mug lead time. This part of the timeline is highly variable and depends on freight availability, port congestion, and customs efficiency.

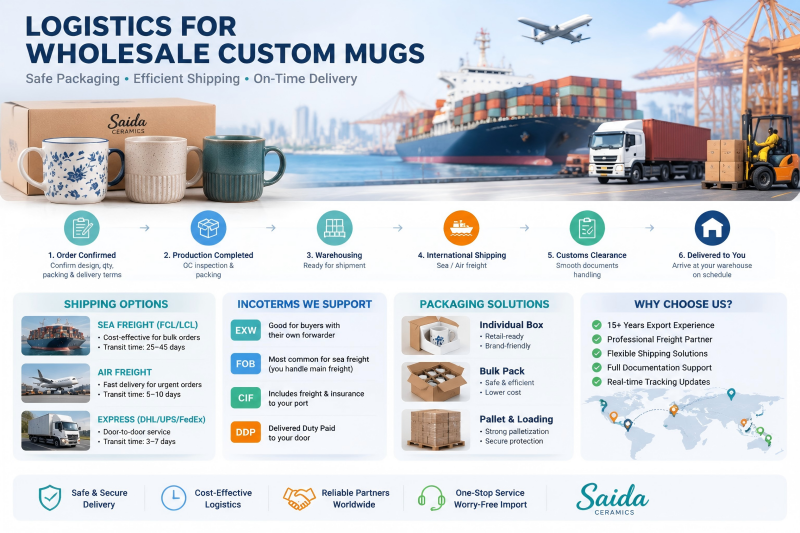

Shipping containers at a port, illustrating the logistics phase of importing wholesale custom mugs.

Dive Deeper: From Factory Door to Your Warehouse

Many first-time importers focus heavily on the production timeline and underestimate the time and complexity of logistics. In my 15 years as an exporter from a ceramic mug factory China, I've seen more "on-time" orders miss their market deadlines due to shipping delays than production issues.

H3: Choosing Your Shipping Method

You have two main choices for international freight, and each comes with a significant trade-off between speed and cost.

Shipping Method Typical Transit Time (China to US/EU) Cost Best For
Sea Freight 30–50 days $$ Large volume orders (wholesale custom mugs) where cost per unit is critical.
Air Freight 7–12 days $$$$$ Small, urgent orders or high-value samples. The cost is often prohibitive for bulk mugs.

For nearly all our clients, sea freight is the only economically viable option. The 30-50 day transit time is just for the ocean voyage. You also have to add time for ground transport to the port of departure, waiting for vessel space, and ground transport from the destination port to your warehouse.

H3: Navigating Customs Clearance

Once the vessel arrives, your container doesn't just roll off and head to your warehouse. It must be processed by customs officials in your country. This can take anywhere from 2 to 10+ days, assuming all your paperwork is perfect.

Delays here are common and are caused by:

  • Incorrect Paperwork: Wrong tariff codes, inaccurate value declarations, or missing certificates.
  • Random Inspections: Customs agencies can flag any shipment for a physical inspection, which can add a week or more to the process.
  • Port Congestion: During peak seasons (like the months leading up to Christmas), ports can become backlogged, and your container might wait days just to be unloaded.

This is where working with a good partner helps. A reliable supplier, like those found by following a guide on How to Find Reliable Ceramic Mug Manufacturers, will provide accurate documentation. A good freight forwarder will help you navigate the process smoothly. But even with the best partners, you must build a buffer into your timeline for these potential delays.


So, What Should My Overall Mug Production Timeline Look Like?

We've looked at pre-production, manufacturing, and logistics as separate phases. It can feel like a lot to juggle, and the risk of one phase delaying the next is real. The best way to manage this is to stop thinking forward from your order date and start planning backward from your deadline.

To be safe, your total mug production timeline should be planned for 4 to 5 months from initial contact to having the mugs in your warehouse. This provides a realistic schedule with a built-in buffer for the unexpected.

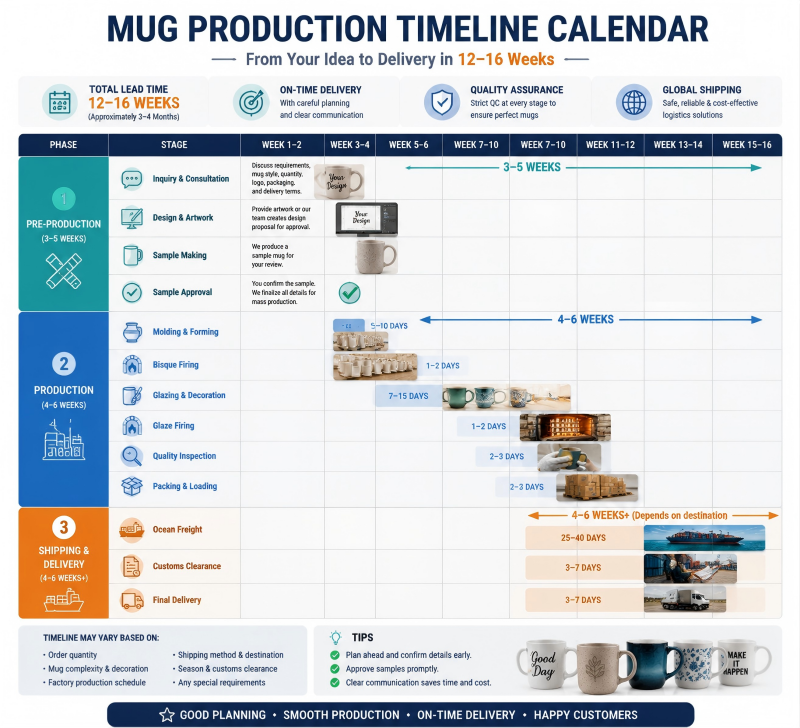

A calendar showing a 5-month mug production timeline for a Christmas promotion.

Dive Deeper: Planning Backward for Success

Let's use a real-world example. Imagine you're an e-commerce seller who wants to launch a new line of Christmas-themed mugs. Your target is to have them in stock and ready to sell by November 1st.

Here is how a professional importer would plan this backward:

  • Goal: Mugs in warehouse by November 1st.
    • Logistics (Buffer Included): Account for 45-60 days. This means your goods must be finished and leave the factory no later than September 15th.
    • Mass Production: Account for 45 days. This means you must approve the final sample and place the bulk order by August 1st.
    • Sampling & Revisions: Account for 2-3 weeks. This means you need to finalize your design and start the sampling process by mid-July.
    • Design & Supplier Discussion: Account for 1-2 weeks. This means your first contact with a potential OEM ceramic mug manufacturer should happen around July 1st.

By starting your project in early July for a November 1st in-hand date, you've built a 4-month timeline with a small buffer. A rookie mistake would be to contact a supplier in October, hoping for a Christmas delivery. With production and shipping times, that's simply impossible.

This "plan backward" method shifts your mindset. You are no longer passively asking, "How long will it take?" Instead, you are proactively creating a schedule that protects your business goals. Your supplier becomes more than a vendor; they become a project partner who helps you hit these critical dates.

Frequently Asked Questions

Can I rush my custom mug order?

Yes, it's sometimes possible, but it comes with costs and risks. Expediting means paying for air freight instead of sea, which can increase your per-unit cost dramatically. It might also require paying overtime at the factory. Rushing also removes any buffer for potential QC issues or shipping delays, increasing your project's risk.

What is the single biggest cause of delays in custom mugs production time?

In my experience, the biggest and most common delays happen during the pre-production phase. Vague feedback on samples, low-quality design files, and slow communication can easily add weeks to a timeline before a single mug is even made. Clear, prompt communication is the best way to prevent this.

Does the time of year affect production lead times?

Absolutely. The most significant period is Chinese New Year (usually late January/early February). Factories shut down for 2-3 weeks. Production halts, and there's a rush to ship goods out before the holiday and a backlog to work through after. You must add at least 3-4 weeks to any timeline that crosses this period.

How much buffer time should I add to my project timeline?

I always recommend clients add a buffer of at least 2-3 weeks to their total project plan. For a critical, can't-miss deadline like a holiday promotion, a 4-week buffer is even safer. This accounts for potential delays in shipping, customs, or unexpected production issues without jeopardizing your launch.

Conclusion

The answer to "how long does it take to produce custom mugs?" is more complex than a single number. The real takeaway is that your success depends on managing a full project timeline, not just a production window. By understanding the three key phases—pre-production, manufacturing, and logistics—and planning backward from your in-hand date, you shift from being a passive buyer to a proactive project manager. This approach dramatically reduces the risk of missing a critical sales window. A realistic view of the custom mugs production time and a solid plan are your best tools for success.

If you're looking for an experienced partner to help guide you through this process for your next order of wholesale custom mugs, please reach out to our team. We've been helping clients in Europe and the Americas successfully navigate these timelines for over 15 years, and we're ready to help you plan your next project.
